A coating line can have well-selected pretreatment equipment, a suitable conveyor, and a properly sized curing oven, yet still deliver inconsistent results if these systems are designed independently.
The main challenge is coordination. Workpieces must reach the spraying area with the required surface condition, move through each process at a suitable pace, and receive the correct curing conditions before unloading. A mismatch between any two stages can reduce production capacity, increase defects, or create unnecessary operating costs.
When designing an integrated coating line, the key is to match the three systems to the same workpiece requirements and production cycle.
Pretreatment Determines What the Coating Process Must Achieve
Pretreatment is not simply the first machine in a coating line. It establishes the surface conditions required for the subsequent coating process.
The appropriate method depends on the substrate, existing surface contamination, coating system, and required corrosion resistance. For example, metal parts with oil or grease may require degreasing, while steel components with rust or mill scale may need mechanical surface preparation or a suitable chemical treatment.
The process must also account for rinsing, drying, and the condition of the workpiece before coating. Residual chemicals, moisture, or contamination can interfere with coating adhesion or surface appearance.
Integration becomes particularly important when the pretreatment process has a different cycle time from the spraying and curing stages. If parts leave pretreatment faster than the next stage can accept them, accumulation may occur. If the following stages run too quickly, the pretreatment process may not provide sufficient contact time.
The solution is not necessarily to increase the speed of every machine. The pretreatment method, treatment duration, transfer arrangement, and production rhythm must be evaluated together.

The Conveyor Connects Process Timing and Workpiece Handling
A conveyor does more than move products between machines. Its speed, loading pattern, and workpiece spacing influence how the entire line operates.

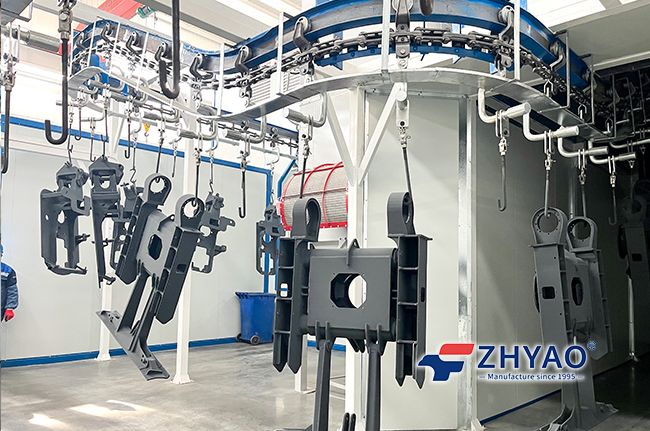

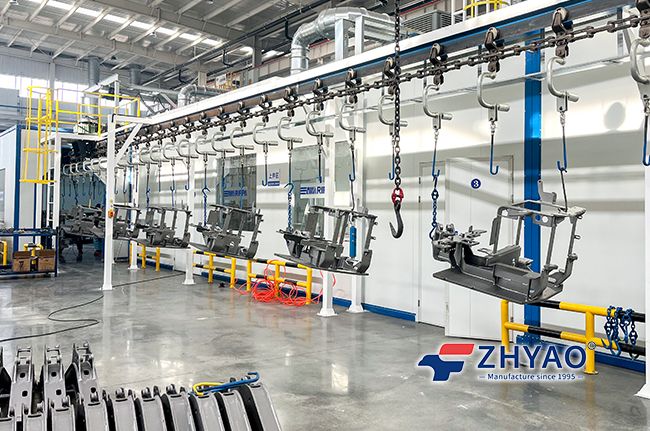

For a continuous coating line, the conveyor speed must be compatible with the required pretreatment exposure, spraying time, and curing residence time. Hanger spacing and workpiece orientation also affect production capacity and process access.
Consider long metal profiles or fabricated steel components. If they swing during transportation or are suspended too closely together, they may obstruct spray access or create uneven spacing in the curing oven. Large workpieces may also require special loading arrangements to prevent collisions and maintain stable movement.
For products with different dimensions and weights, the conveyor should be designed around the actual product range rather than a single representative workpiece.
A batch system may be more appropriate when production involves frequent product changes, different treatment cycles, or irregular processing requirements. Continuous conveying is often suitable for repetitive production with a relatively stable process sequence.
Neither arrangement is universally better. The choice depends on production volume, product variety, available space, and the degree of process separation required.
Curing Capacity Must Match the Actual Production Cycle
Curing is a common source of bottlenecks because oven capacity is sometimes evaluated by its physical dimensions rather than the requirements of the coating process.
For powder coating, the workpiece must reach the specified metal temperature and remain at the required temperature for the time defined by the powder manufacturer's curing schedule. The oven air temperature alone does not confirm that the coating has received sufficient curing.
Thick steel components, thin sheet-metal parts, and aluminum profiles can heat at different rates. Consequently, products with different thermal characteristics may require different residence times or operating conditions.
In a continuous line, the required oven length is closely related to conveyor speed and residence time. If the conveyor runs too fast for the available heating length, the workpiece may not receive sufficient curing. Slowing the entire line may solve this problem, but it can also reduce output at every upstream stage.
A better approach is to calculate the required curing time, evaluate the workpiece heating behavior, and determine whether the oven length, heating capacity, airflow, and conveyor speed are compatible.
Where products have significantly different curing requirements, production scheduling or separate curing arrangements may be necessary.

Three Integration Problems That Commonly Reduce Line Efficiency
1. Pretreatment and coating operate at different production rates
The pretreatment system may process parts continuously, while operators load the spraying area in batches. Without suitable buffering or coordinated loading, this difference can cause congestion or leave downstream equipment waiting.
The design should establish the target output for each stage and identify where temporary accumulation is needed. Buffer capacity should reflect actual cycle-time differences rather than being added without a production reason.
2. Conveyor speed is selected before curing requirements are confirmed
A conveyor speed that meets the target output may not provide enough oven residence time. Conversely, designing the entire line around an unnecessarily long curing cycle can limit production.
The required curing schedule should be established early, then used to check conveyor speed and oven dimensions. Any proposed increase in output should be assessed against the thermal requirements of the actual workpieces.
3. Workpiece spacing is inconsistent
Uneven loading changes the number of parts entering each section per hour and can affect spray access and oven airflow. Closely spaced parts may also interfere with one another during transport.
Defined hanger positions, loading procedures, and spacing requirements help maintain a more predictable production rhythm. The appropriate spacing depends on workpiece geometry, coating access, and the characteristics of the equipment.
Design the Line Around One Production Target
The three systems should be evaluated as parts of one process rather than as independent equipment packages.
Before finalizing a coating line, establish the following:
Workpiece range: Material, dimensions, weight, and surface condition.
Required output: Parts per hour or per shift, including planned production interruptions.
Pretreatment requirements: Treatment method, contact time, rinsing, and drying conditions.
Conveyor arrangement: Loading method, hanger spacing, transport speed, and transfer requirements.
Curing conditions: Coating specifications, workpiece heating behavior, required residence time, and oven capacity.
These details allow the design team to identify the likely bottleneck before equipment is manufactured or installed.
For existing lines, the same logic helps determine whether the main problem comes from pretreatment capacity, conveyor timing, or curing performance. Improving one stage without checking the others may simply move the bottleneck elsewhere.
A Practical Approach to Coating Line Integration
The most effective integration begins with the required coating result and production output. From there, the pretreatment process establishes the necessary surface condition, the conveyor coordinates movement and timing, and the curing system provides the required thermal conditions.
When these requirements are considered together, manufacturers can reduce avoidable waiting time, maintain more consistent processing conditions, and make better use of installed equipment.
The objective is not to make every stage run as fast as possible. It is to ensure that each stage can support the next one without compromising coating quality or production stability.
FAQ
1. How does conveyor speed affect pretreatment and curing?
Conveyor speed determines how long workpieces remain in each process section. It must be compatible with pretreatment contact time and the required curing residence time. Actual curing performance also depends on workpiece temperature and the coating manufacturer's specifications.
2. Can one coating line handle different workpiece sizes?
Yes, if the conveyor, hanger arrangement, spray equipment, pretreatment capacity, and oven are designed for the intended product range. Large differences in weight, geometry, or curing requirements may require adjustable configurations or separate production schedules.
3. What should be checked first when an integrated coating line cannot meet its target output?
Identify where workpieces accumulate or equipment remains idle. Then compare actual cycle times, conveyor speed, pretreatment capacity, and curing requirements. This helps locate the real bottleneck before investing in additional equipment.
